Skip to main content

What is Data Migration? Strategy, Steps, and Best Practices

Data migration illustration showing data moving between databases with strategy, best practices, and tools.
Written bySenior Data Engineer
Technically reviewed byUsman AshrafPrincipal Data/AI Architect
Published
Updated
Reading time
15 min

Summarize with AI

Introduction

Data migration is the process of moving data from one storage system, format, or application to another. Common examples include moving from a legacy ERP to a cloud platform, or from an on-premise database to a cloud warehouse.

Many teams treat a migration as a copy job. Reality is messier than that. The source data is dirty, and the business rules sit buried in undocumented scripts. A field that meant one thing in 2014 means something else today, and validation often gets left until the very end.

This guide covers the types of data migration, how to choose a strategy (big bang, phased, or parallel), and the 7-step process our engineers follow on client projects. It also includes a planning checklist and the warning signs that a migration is in trouble.

What is Data Migration?

Data migration is the process of moving data from one storage system, format, or application to another. Data migration usually happens when:

  • An old system is being retired.
  • A company moves its infrastructure to the cloud.
  • A merger forces two databases into one.

The core job is to get the records across without losing or corrupting them. Migration sounds easy until you count the records, since a mid-sized company can hold tens of millions of rows across dozens of tables.

Most migrations follow three steps, which engineers call ETL.

  • Extract the data from the source.
  • Transform it to fit the target system’s structure and rules.
  • Load it into the target.

However, migration adds one thing ETL pipelines often skip. The source system gets switched off at the end, so there is no fallback if something goes wrong.

Data Migration Examples

Four common scenarios show what makes a migration hard in practice.

  • ERP Replacement: The data models of the old and new ERP rarely line up, so transformation takes most of the effort.
  • Product Catalog (PIM) Move: Attributes, variants, and category trees often follow different rules in each system.
  • MySQL to PostgreSQL: Data types and stored procedures behave differently in each engine.
  • On-Premise Warehouse to Snowflake: Years of SQL logic and scheduled jobs have to be rebuilt and checked against the old reports.

Data Migration vs Data Integration vs Data Conversion vs Replication

These four terms get mixed up often, but each one does a different job. The table below compares them by purpose, duration, what happens to the old system, and typical tools.

Term

Purpose

Duration

Old System After

Typical Tools

Data Migration

Move data to a new system for good

One-time project

Retired

ETL platforms, cloud migration services

Data Integration

Keep live systems in sync

Ongoing

Stays live

ELT connectors, iPaaS, APIs

Data Conversion

Change data from one format to another

One-time step, often inside a migration

Usually retired

Scripts, transformation tools

Data Replication

Keep a copy of data in another location

Ongoing

Stays live

CDC tools, database replication

Migration ends, while integration keeps running. A full breakdown of data migration vs data integration explains when you need each.

Types of Data Migration

There are six main types of data migration, and most projects mix a few. The type decides which tools fit and where the risk sits.

Storage Migration

Storage migration moves data to a new storage medium, such as from on-premise arrays to Amazon S3. The data itself does not change, so this is usually the lowest-risk type. The main risk is broken file paths and permissions.

Database Migration

Database migration moves data between database engines or versions, such as from MySQL to PostgreSQL. Data types, stored procedures, and triggers often need rewriting for the new engine. A warehouse-to-lake move is a related case, covered in the guide to data warehouse to data lake migration.

Application Migration

Application migration moves data when a company swaps software, such as a legacy ERP for a cloud platform. The data models rarely line up, so transformation work takes most of the effort.

Cloud Migration

Cloud migration moves data and workloads from on-premise infrastructure to a cloud provider, or between clouds. Rehosting (the lift-and-shift approach) held a 35.4% share of cloud migration work in 2025, because it is the fastest first step. The guide to cloud data migration strategy covers planning for this type.

Data Center Migration

Data center migration moves applications, storage, and networking to a new physical or virtual location. The main risk is a missed dependency between applications, which only shows up after cutover. The data center migration guide covers the planning.

Business Process Migration

Business process migration moves data after a change in how the business runs, such as a merger. It often pulls in several other types at once, which makes it the hardest type to scope.

Data Migration Strategy: How to Choose Your Approach

A data migration strategy is the set of decisions made before any data moves. The right approach depends on your downtime tolerance, your data volume, and how tightly your systems are linked.

What a Data Migration Strategy Includes

A written strategy covers eight decisions. Each one needs an owner and a sign-off before the build starts.

  1. Scope: What moves, what gets archived, and what gets dropped.
  2. Approach: Big bang, phased, or parallel, plus the reason for the choice.
  3. Cutover Window: When the switch happens and how long the outage lasts.
  4. Data Quality Rules: The standards data must meet before it loads.
  5. Mapping: How each source field maps to a target field.
  6. Validation: How the team proves the data is complete, with agreed acceptance thresholds.
  7. Rollback: How the business switches back, and who makes the call.
  8. Governance: Who approves changes to scope, rules, and dates.

Big Bang vs Phased vs Parallel

The three approaches trade downtime against cost and complexity. A big bang migration moves everything in one window, usually over a weekend. A phased migration, also called trickle migration, moves data in stages while both systems run. A parallel migration runs both systems on live data until the results match.

Factor

Big Bang

Phased (Trickle)

Parallel Run

Downtime

Planned outage window, downtime required

Minimal, migration happens in stages

Near zero, both systems stay live

Risk

Higher, concentrated in one window

Lower, spread out over time

Lowest, outputs compared before the switch

Cost

Lowest

Medium

Highest, two systems run at once

Complexity

Simplest to plan

Two systems must stay in sync

Two systems plus output comparison

Best For

Small datasets, short outage accepted

Large or critical data

Billing, finance, and regulated data

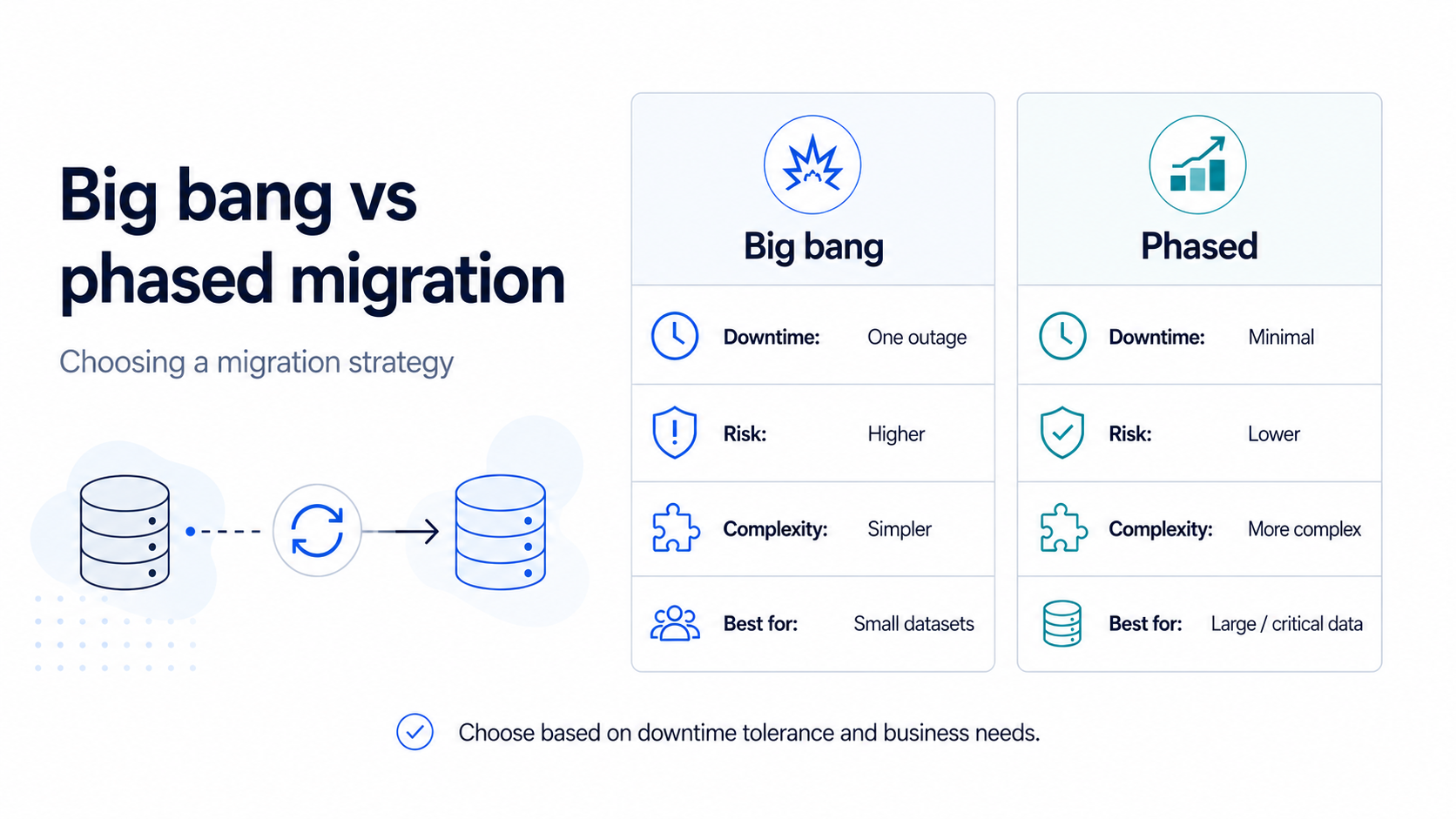

Comparison of big bang and phased data migration strategies by downtime, risk, complexity, and suitable data size.

A big bang move is the cheapest to run, but any failure in the outage window hits the business at once. This approach suits small datasets and teams that can absorb a short outage.

A phased move lowers risk, because problems surface early while both systems run. The cost is extra engineering work to keep the two systems in sync.

A parallel run costs the most, since the business runs two systems side by side for weeks. In return, the switch happens only after the outputs match, which is the usual route to a zero-downtime migration.

How to Choose Your Migration Approach

Four questions narrow the choice quickly.

  1. Downtime Tolerance: A business that can accept a weekend outage can use big bang.
  2. Data Volume: Tens of millions of rows across many tables usually need phases.
  3. Source Data Quality: Dirty data needs more test cycles, which favors phased or parallel.
  4. System Coupling: Tightly linked systems are hard to split, so a parallel run often works better.

The guide on migration risk planning covers how to weigh these answers with leadership.

A Repeatable Data Migration Methodology

A methodology turns the strategy into a cycle the team repeats for each wave of data. Assess and Plan, the first two of the seven steps below, run once per project. Design, Cleanse, Migrate, and Validate then repeat for each wave, and Decommission closes out each wave’s source tables.

Each step ends at a governance gate, where the data owner signs off before the next one starts. The first wave is usually a low-risk set of tables, so later waves can reuse its scripts and run faster.

The Data Migration Process: 7 Steps

The data migration process runs in seven steps, and skipping the early ones is where most projects lose the plot. This is the same process we follow when managing migration projects for our clients. Each step ends with a deliverable and an exit criterion, so the team knows when it is safe to move on.

Step 1: Assess and Profile the Source Data

  • What Happens: Count records per table, find duplicates and empty fields, and identify unused tables and hidden business logic.
  • Deliverable: A data profiling report and a scope list of what moves, gets archived, or is dropped.
  • Exit Criterion: The data owner signs off on record counts and quality issues before the budget and timeline are fixed.

Step 2: Plan the Scope, Owners, and Timeline

  • What Happens: Set the scope, owners, success criteria, and a realistic timeline built on the assessment rather than a hunch.
  • Deliverable: A migration plan with the scope list, a roles table, the timeline, and the budget.
  • Exit Criterion: The executive sponsor and the data owner approve the plan.

Step 3: Design the Mapping and Transformation Rules

  • What Happens: Map every source field to its target field and write the transformation rules. Define how to handle records that do not map cleanly, because there will be plenty of them.
  • Deliverable: A mapping specification covering every field in scope.
  • Exit Criterion: Business owners sign off on the mapping for every field in scope.

Step 4: Cleanse the Source Data

  • What Happens: Fix quality problems at the source where you can. Deduplicate, standardize formats, and either fill or flag the gaps.
  • Deliverable: A data quality report showing defect counts before and after cleansing.
  • Exit Criterion: Defect rates fall below the thresholds agreed in the strategy.

Step 5: Migrate the Data in Batches

  • What Happens: Run the extract, transform, and load. For large datasets, move in batches so a single failure does not take down the whole run.
  • Deliverable: Load logs and a run record for every batch.
  • Exit Criterion: Every batch has loaded with no unresolved errors.

Step 6: Validate the Migrated Data

  • What Happens: Reconcile row counts, compare checksums, test referential integrity, and run business-rule checks on sample records. Teams rush this step, and it is the one that causes silent corruption. The guide on how to validate migrated data covers each test in detail.
  • Deliverable: A reconciliation report for every table in scope.
  • Exit Criterion: Results fall within the acceptance thresholds, and business validators sign off.

Step 7: Decommission the Old System

  • What Happens: Once validation passes and the new system runs stably, set the old system to read-only for a defined window, then archive it and shut it down.
  • Deliverable: A decommission record and a verified archive of the source data.
  • Exit Criterion: No open issues remain at the end of the read-only window.

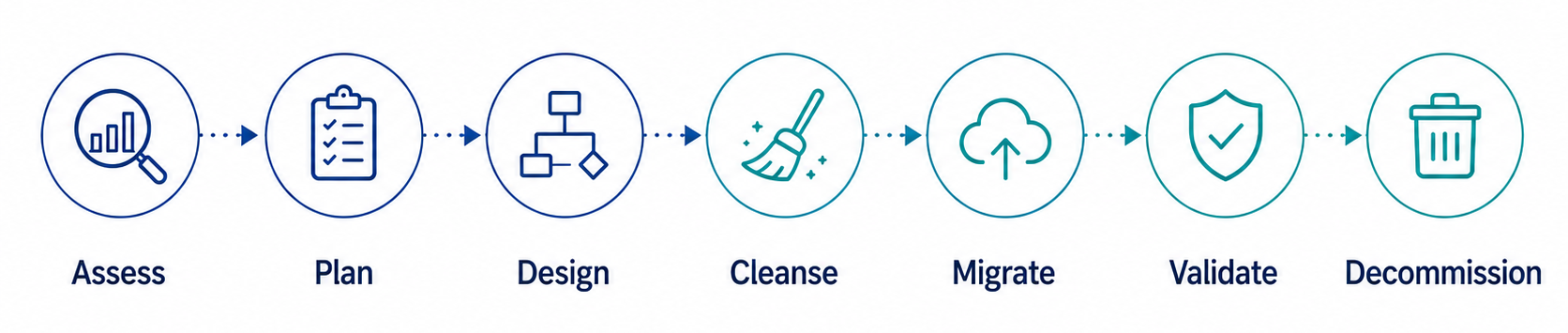

Seven-step data migration process from assessment and planning through validation and system decommissioning.

Data Migration Planning and Management

Data migration management covers the people, time, and money around the technical work. Most overruns start here, because roles stay vague and budgets get set before anyone profiles the data.

Roles and Responsibilities

Every migration needs five roles, even when one person covers two of them. The RACI table below shows who is Responsible (R), Accountable (A), Consulted (C), or Informed (I) at each stage.

Role

Scope and Plan

Mapping and Rules

Build and Load

Validation

Go or No-Go

Executive Sponsor

A

I

I

I

A

Data Owner

C

A

I

A

R

Migration Lead

R

R

A

R

C

Data Engineers

C

R

R

R

I

Business Validators

C

C

I

R

C

The trade-offs between consultants vs an in-house migration decide who fills the engineering roles.

How Long a Data Migration Takes

A data migration can take a few weeks or more than a year. Duration depends on five drivers rather than a standard number.

  • Data Volume: More tables mean more mapping work and more validation runs.
  • Source Data Quality: Every quality problem adds a cleansing and retest cycle.
  • Hidden Business Logic: Rules buried in old scripts must be found and rebuilt.
  • Migration Approach: Phased and parallel migrations run longer than a big bang.
  • Sign-Off Speed: Slow reviews add weeks at every gate.

The assessment in step 1 gives the first estimate worth trusting.

What Drives Data Migration Cost

Cost follows the same drivers as time, plus a few of its own. Tool licenses charge by volume, rows, or connectors. Phased and parallel approaches also pay for two platforms at once.

Cloud warehouses bill by usage, so the new system needs its own cost forecast. For Snowflake moves, the guide on how to forecast spend before migrating shows how to model the bill.

Metrics to Track

Four metrics show whether a migration is on track.

  • Rows Reconciled: The share of source rows matched in the target.
  • Defect Rate: Records failing quality or business rules, as a share of rows loaded.
  • Cutover Duration: Actual outage time against the planned window.
  • Rollback Readiness: How recently the rollback was rehearsed and how long it takes.

Data Migration Checklist

A checklist keeps each phase honest, because nothing moves forward until every item is ticked. Use the three lists below before, during, and after cutover.

Before Migration

During Cutover

After Migration

Why Data Migrations Fail and the Warning Signs

Most data migrations fail for business reasons rather than technical ones. Four causes come up again and again, and each one leaves warning signs before go-live.

Poor Data Quality

Research by Experian found that 48% of organizations in the Asia Pacific region face migration delays because of data quality issues. Duplicate records, missing fields, and inconsistent formats cause most of these delays.

Treating Migration as a File Transfer

Teams that treat migration as a file transfer skip discovery and underestimate the work. The gap shows up later, when records in the old and new systems do not match.

Hidden Business Logic

Years of one-off fixes sit in stored procedures, macros, and scripts. This logic does not move with the data unless someone finds it and rebuilds it.

Weak Planning

Experian found that 29% of organizations named a weak data strategy or a lack of the right technology as their main bottleneck. Budgets set before the data is profiled are usually wrong.

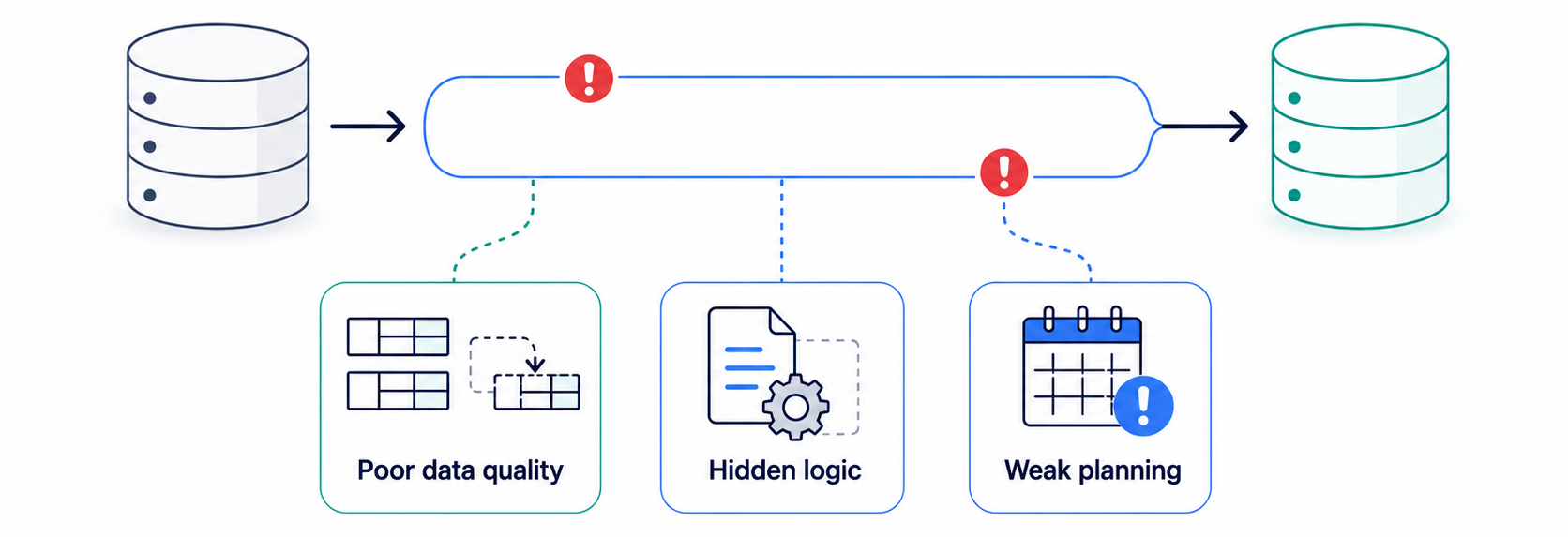

Diagram showing a data migration pipeline disrupted by poor data quality, hidden logic, and weak planning.

Warning Signs a Migration is in Trouble

Each of these causes shows up early if you know where to look.

  • Budget Before Profiling: The budget and timeline were set before anyone analyzed the source data.
  • No Firm Record Count: The team cannot confirm how many records it has and gives an estimate instead.
  • Validation Only at the End: Checks are planned for after the final load rather than after every batch.
  • No Rollback Plan: Nobody can say how the business would switch back if the new system fails.

Two deeper guides cover why cloud data migrations fail even with strong engineers, and why cloud migration projects fail with a fix for each cause.

Data Migration Best Practices

Good migrations share a short list of habits. After dozens of projects, these are the ones that separate a clean cutover from a 3 AM scramble.

  • Profile the Data First: Run a full data quality assessment before you commit to a budget or a go-live date.
  • Migrate in Batches: Smaller batches give you checkpoints and a clean way to retry just the part that broke.
  • Validate After Every Batch: Automated reconciliation catches the records that manual spot-checks miss.
  • Validate With Four Methods: Row counts, checksums, referential integrity tests, and business-rule samples each catch errors the others miss.
  • Freeze Changes During Cutover: A schema change or new entry made mid-cutover leaves records that exist in only one system.
  • Keep a Tested Rollback Plan: A verified backup and a documented rollback path turn a disaster into an inconvenience.
  • Bring the Business in Early: The people who use the data know what correct looks like, so pull them into validation from the start.

Data Migration Tools

The right data migration tool depends on the type of migration and where the data lives. The market has grown fast, from about $10.8 billion in 2025 toward a projected $31 billion by 2034, as cloud adoption pulls more projects into scope. The table below groups the main options by the job they do.

Tool Type

Examples

Best For

Cloud Provider Services

AWS DMS, Azure Database Migration Service, Google Cloud Database Migration Service

Moves into that provider’s cloud

ETL and ELT Platforms

Informatica, Talend, Fivetran

Many sources and repeatable loads

Transformation Layer

dbt

Rebuilding business logic in the warehouse

Custom Pipelines

Python, SQL

Unusual business rules and messy sources

Most real migrations pair a provider service for the heavy lifting with custom scripts for the parts that refuse to fit a template. Let the tool handle the bulk movement, and keep your engineering time for the transformation logic that encodes how your business works. DBT has become a common choice for this transformation layer, especially on warehouses like Snowflake and BigQuery.

For a closer look, a separate guide has ten data migration tools compared by pricing and fit. A breakdown of ETL tools for migrations also covers billing models and deployment options.

Next Steps

Everything above starts with knowing your data. If you are planning a migration, spend the first week profiling the source to find quality issues, inconsistencies, and dependencies before you choose any tools. A free data quality assessment gives you a quick first read on where the problems sit.

Some projects are too large or too risky to run alone. The guide on when you need migration consulting offers a short test to help you decide. For hands-on help, our data migration services cover the full process from assessment to decommissioning.

Book a Free 30-Minute Meeting

Discover how our services can support your goals — no strings attached. Schedule your free 30-minute consultation today and let's explore the possibilities.

Book a Free Call

Frequently Asked Questions

Data migration is a one-time transfer from a source to a target, after which the source is typically retired. In contrast, ongoing data integration keeps data synchronized between live systems. Migration ends, while integration continues.

Timelines vary based on data volume, quality, and complexity, ranging from weeks to over a year. Larger, messier datasets can take 12 months or more, with the assessment phase providing the most accurate timeline.

Poor data quality and weak planning cause most data migration failures and overruns, rather than the migration technology. Profiling the source data before setting a budget is the single best way to lower that risk.

Most datasets contain stale, duplicate, or unused records that increase cost and risk without adding value. A good migration archives or removes this data, transferring only what the new system requires.

Cost depends on volume, complexity, and data cleanliness. For Snowflake projects, you can use our Snowflake cost calculator for estimates. Budget overruns often reach 30% on delayed projects, making a discovery phase that provides a solid estimate worthwhile.

The three main approaches to data migration are big bang, phased, and parallel. A big bang migration moves everything in one planned outage window. A phased migration moves data in stages while both systems run. A parallel migration runs both systems on live data until the results match, then switches over.

A data migration runs in seven steps. The team assesses the source data, plans the scope, designs the mapping, cleanses the data, migrates it in batches, validates the result, and retires the old system. Each step ends with a deliverable, such as a profiling report or a reconciliation report, and the next step starts only after sign-off.

In a database management system (DBMS), data migration means moving tables, records, and database objects from one database to another. Examples include moving from MySQL to PostgreSQL, or from an on-premise SQL Server to a cloud database. The work usually covers schema conversion, data type mapping, and rewriting stored procedures. SQL queries then compare row counts and values between the source and the target.

Data migration lets a company retire old systems, move to the cloud, or combine data after a merger without losing records. A well-run migration keeps reports, billing, and daily operations correct through the change. A poor one leaves missing or wrong data in the new system, often found only after the old system is gone.

Book Consultation
